How to Calculate Actual vs. Estimated Landscaping Costs

The Key to Accurate Estimating: Tracking Actual vs. Estimated Performance

You’re busy. Crews are working full weeks. The schedule’s packed from early spring through late fall, and your revenue looks strong. But when you review your numbers, the profit feels a little thinner than it should.

If that sounds familiar, the issue often comes down to one thing: the gap between what you estimated and what actually happened on the job. When you understand actual vs. estimated landscaping performance, you stop guessing at profit, and you start managing it like the professional you are.

Table of Contents

  1. The Definition: Understanding the gap between your plan (the estimate) and your reality (job costing).
  2. The Growth Factor: Why actual vs. estimated performance is a more important metric than total revenue.
  3. The Profit Leak Cheat Sheet: Identifying the hidden gaps in labor, materials, and overhead recovery.
  4. The Math of Variance: Three simple calculators to reveal the truth behind your production rates.
  5. The 4-Step System for Predictable Profit: How to build a repeatable system for calculating performance on every job.
  6. The Software Solution: Closing the gap by integrating estimating and job costing into a single system of record.
Actual vs. Estimated Landscaping Performance Definition

What “Actual vs. Estimated” Really Means in Landscaping

Actual vs. Estimated performance is the process of comparing your original bid (the estimate) to the end-of-project costs (the actual) to ensure your future estimates are accurate and profitable.

At its core, actual vs estimated is simple. It means comparing:

  • The hours you bid versus the hours you used
  • The materials you priced versus the materials you installed
  • The overhead you planned to recover versus what you actually covered
  • The profit you expected versus the profit you earned

Here’s the relationship in plain terms: Estimating is your bid. Job costing is reality. The difference between the two is your variance.

When you don’t measure that variance, you’re essentially guessing on your next bid, allowing profit erosion to hide inside busy schedules and long workdays.

Why Actual vs. Estimated Performance Matters More Than Revenue

Revenue can hide mistakes, but margin reveals them.

You can grow from one million to three million in annual sales and still struggle with cash flow. If labor runs high and material waste creeps up, revenue growth only magnifies the problem.

Landscaping profitability depends on repeatable margins, and not just full calendars.

When you compare estimated vs. actual job costs consistently, you can:

  • Build Bulletproof Production Rates: Identify exactly where crews outperform or lag behind the estimate. Use this real field data to update your estimating labor assumptions, ensuring future bids reflect how work actually gets done.
  • Modify Markups to Protect Margins: If materials or subcontractor costs are trending higher than projected, you can modify your markup to protect margin. This keeps your pricing aligned with real expenses and prevents small cost increases from quietly eroding your profits.
  • Set Clear Goals For Your Crews: Give your crews clear goals by sharing “hours sold” versus “hours used.” This turns estimating into a coaching tool, driving accountability and field efficiency.
  • Refine Your Bidding Templates: Every completed job becomes a learning opportunity. By reviewing where estimates were tight or loose, you can tighten templates and production standards, so each new proposal becomes more accurate than the last.
  • Build Predictable Profit: When estimating and job costing align, margins will stop fluctuating wildly from job to job. That consistency helps you forecast cash flow, plan growth, and make confident business decisions based on data-driven pricing.

This kind of discipline turns estimating and job costing into operational systems instead of paperwork.

Where the Gap Shows Up on Real Jobs

Profit rarely disappears in one dramatic event. It slips away in small, repeated overages that reveal a gap in your estimating logic. Here is where those hidden leaks usually live:

The Profit Leak Cheatsheet

CategoryThe LeakThe Software Fix
LaborUntracked loading time, drive time, and setup/cleanup.Link mobile time-tracking directly to the estimated job budget
MaterialsUnderestimating mulch depth or failing to account for sod shrinkage.Update waste factors in your bidding templates based on actual usage.
OverheadRising fuel, insurance, and admin costs left out of the bid.Use a budget-first approach to ensure every hour sold covers the bills.
EquipmentUnaccounted idle time or specialized tool rentals.Log equipment hours against the job to refine your hourly rates.

Labor Overages

Labor is where most landscaping businesses lose margin. Think about what happens on a typical week:

  • The Leak: A crew clocks in 15 minutes before loading. Drive time to a 12-acre commercial site takes longer than planned. Setup and cleanup stretch 20 minutes longer than expected. Overtime hits during peak season.
  • The Math: You estimated 120 labor hours for a monthly maintenance contract, but the actual time hit 145 hours. At a $42 per hour burdened labor rate, that 25-hour overage is a $1,050 invisible tax on your profit.
  • The Lesson: If you don’t adjust your estimating production rates to account for labor overages, you’re underpricing on the next 40 jobs you win.

Materials and Waste

Material variance often feels small, but it adds up across an entire season. Whether it’s underestimating mulch depth on a 20-bed property or failing to factor in sod shrinkage on a 5,000 square foot installation, these gaps add up.

  • The Leak: Underpricing materials by even just 3% erodes your net margin across every job.
  • The Lesson: Without tracking actual usage, you can’t refine waste factor in your estimating templates, leaving you to pay for those extra pavers out of your own pocket.

Missed Overhead and Soft Costs

Overhead is a quiet profit-killer. Rising insurance premiums, increasing fuel costs, and equipment depreciation are often left out of the bid entirely.

  • The Leak: Administrative time grows as the company grows. If overhead recovery isn’t built into every estimate, growth amplifies the loss instead of strengthening the profit.
  • The Lesson: Actual vs. estimated job costing brings those hidden costs out into the open, allowing you to build a bid that covers the entire business, not just the field labor.

The Simple Formula That Reveals the Truth

You don’t need a finance degree to measure variance. You just need to look at the gap between your plan and your reality.

Use these Estimating vs. Actual Calculators with three basic formulas to see where your estimates stand.

The Math of Variance

The Big Picture (Gross Profit Variance)

Estimated Gross Profit – Actual Gross Profit = Variance

Or in operational terms:

Estimated Revenue – Estimated Costs – Actual Revenue – Actual Costs = Profit Gap

If the number is negative, your estimate didn’t account for the real-world costs of the job.

The Labor Check (Efficiency Variance)

Estimated Labor Hours – Actual Labor Hours = Labor Variance

This tells you if your production rates are realistic or if your crews need better coaching.

The Material Check (Usage Variance)

Estimated Material Cost – Actual Material Cost = Material Variance

This reveals if you need to adjust your waste factor in your bidding templates.

Why This Matter for Your Next Bid

You can calculate this in spreadsheets, and many owners try, but as the job count increases, manual tracking becomes overwhelming. Reports get skipped, data becomes inconsistent, and the feedback loop breaks.

The goal isn’t just to do the math—it’s to do the math fast enough to change how you bid on the next project.

When you identify a $500 labor leak on Tuesday, you can adjust your proposal for the next client on Wednesday. That is how you protect your margins in real-time.

4 Simple Steps to Calculating Actual vs Estimated on Every Job

If you want actual vs. estimated landscaping performance to become a routine part of your business, you need a system that connects the office to the field. Follow these four steps to turn your real-world data into more profitable bids:

Step 1. Build structured estimates.

Use defined labor production rates. Apply burdened labor costs (wages + taxes + benefits). Include overhead recovery and specific markups for every category.

Step 2. Capture actual field data.

Track clock-in and clock-out times. Record actual material usage. Log equipment hours.

Step 3. Review variance weekly.

Compare labor overages and material differences. Review gross margin by job and by crew weekly so you can spot margin leaks and adjust your production rates before they compound

Step 4. Refine your estimating templates.

Adjust production standards and waste factors based on your findings, and modify markups where needed. This creates a continuous loop of improvement.

Estimate. Perform. Measure. Adjust. Improve the next estimate.

By following this 4-step loop, your estimates become a living reflection of your crew’s actual performance, making your landscaping profitability predictable.

Closing the Gap with Landscape Estimating and Job Costing Software

Manual systems break as your company grows, spreadsheets multiply, versions conflict, and data gets buried.

That’s also where connected estimating and job costing software changes the game.

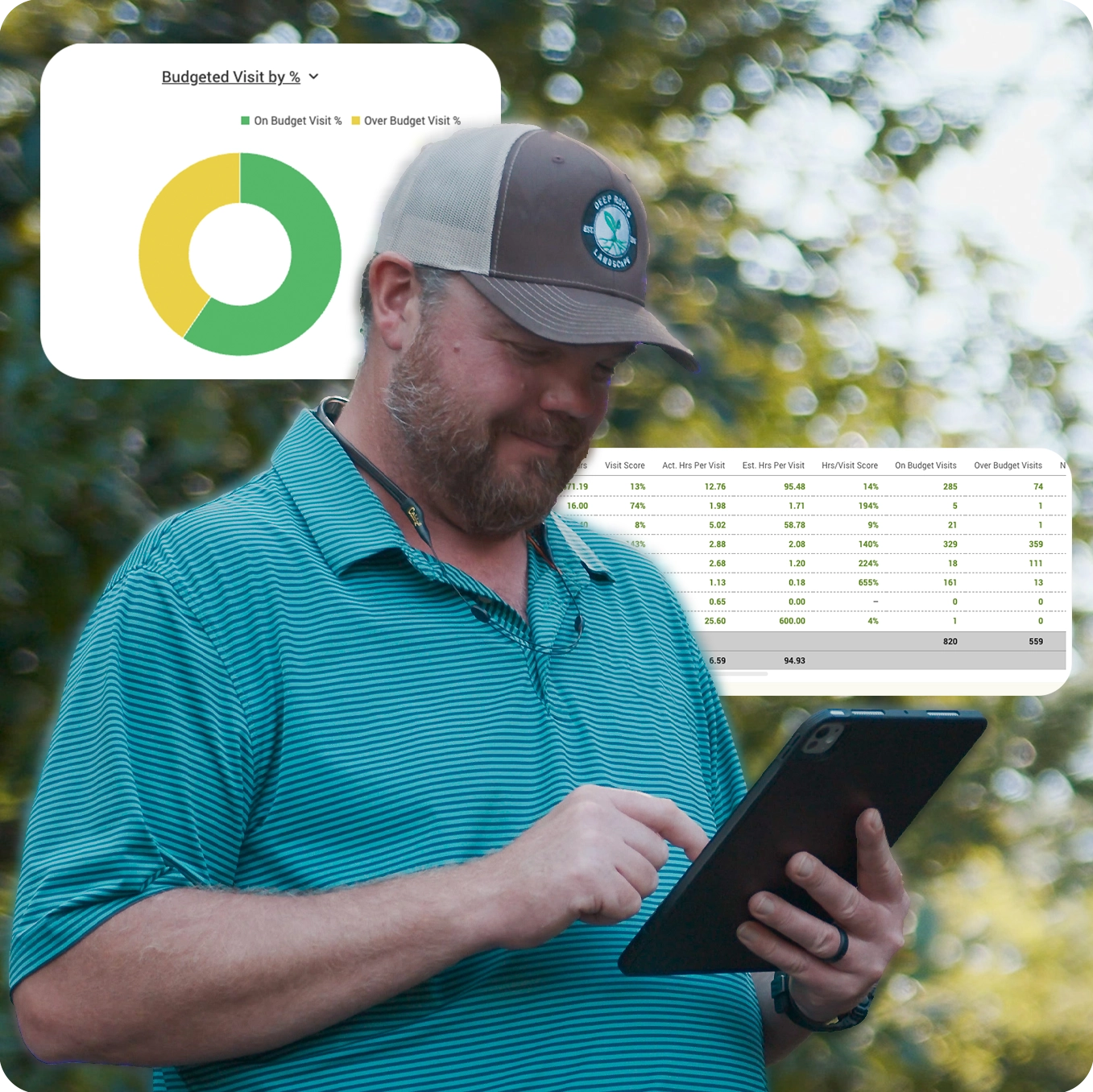

Landscaper using a tablet to calculate their actual vs. estimated landscaping performance using LMN by Granum actual vs. estimated feature

With LMN by Granum, you can build professional estimates using real production rates and built-in overhead recovery. LMN ensures you aren’t just “winning work,” but winning work that covers your bills. Those estimates convert directly into job budgets, so you can see actual hours against estimated hours in real-time.

This will become your system of record, and instead of wondering why profit feels thin, you’ll see exactly where it shifted.

And with Greenius by Granum, you can train your crews on production expectations and safety standards, so the work delivered matches the work sold on a consistent basis.

We don’t just provide tools. We guide you through the implementation phase because your success is our shared mission. When estimating and job costing align, the entire operation becomes stronger.

What a “Good” Estimate Looks Like: Benchmarks and Examples

No matter how experienced you are, zero variance isn’t realistic. Weather shifts, site conditions change, and new crew members have learning curves.

In the green industry, good performance doesn’t mean perfect, but it means controlled. Here are some strong industry benchmarks:

  • Labor Variance: Under 5% to 8%. If you are consistently over this, production rates in your estimating templates likely need an update.
  • Material Variance: Within Planned Waste Factors. Your actuals should align with the 3–5% waste you built into the proposal.
  • Gross Margin: Within 2–3 Points of the Estimate. If you bid a 40% margin, finishing at 38% is a win. Finishing at 30% is a red flag.
Imagine this scenario:

A maintenance company targets a 40% gross margin but averages 32%.

Once they start job costing every visit and reviewing weekly variance reports, patterns jump off the page. They see crews consistently spending extra time on spring cleanups and fall leaf removal that weren’t fully built into their original maintenance packages. Disposal runs, bed edging, and mid-season plant replacements are either underpriced or not listed as separate services at all, so crews do the work, but the margin disappears.

Armed with that data, they adjust their production rates and rebuild their estimating templates. They break bundled work into clear line items, add separate services for cleanups, disposal, and extras, and set labor and material assumptions that reflect what actually happens on site. From there, every new contract automatically prices those services correctly.

Within one season, margins stabilize between 38% and 40%. The result? They don’t work more hours or chase more customers; they simply start charging for the hours and services they were already delivering.

Revenue doesn’t spike overnight, but discipline does, and that improvement flows straight to the bottom line.

From Gut Feel to Data-Driven Decisions

Many owners built their businesses on experience. You know how long it should take to maintain a 15,000 square foot estate or install a 1,200 square foot patio, and that intuition matters.

But as you add estimators, crews, and service lines, gut feel becomes harder to scale.

Software doesn’t replace your judgment. It sharpens it.

When actual vs. estimated performance becomes part of your weekly routine, your bids will improve, your team aligns around numbers, and profit becomes something you manage, not something you hope for.

That’s operational maturity. And it’s achievable.

Build Profit You Can Predict

In the landscaping world, estimating wins the work, and job costing protects profit. When you connect the two, you’ll close the gap between what you bid and what you earn.

If you’re tired of being busy without seeing your margins improve, it may be time to build a stronger feedback loop.

With LMN by Granum, you’ll have the structure to measure performance, refine your bidding estimates, and grow profit with confidence.

We’re here to partner with you as you strengthen your operation. We know the industry, we know the struggle and we know that when your estimates get more accurate, your business gets more sustainable. Because when you succeed, we succeed.

Tired of being busy without seeing your margins improve?

If you’re ready to measure performance, refine your bidding estimates, and grow profit with confidence, book a quick walkthrough of LMN. We will show you how we can help strengthen your operation.

Landscape Estimating Guide & Templates

Frequently Asked Questions

What does actual vs. estimated mean in landscaping?

It means comparing the labor hours, materials, overhead, and profit you planned in your estimate to what actually occurred on the job. The difference between those numbers is your variance.

How often should I compare estimated vs. actual job costs?

You should review variance weekly during the season. Regular review allows you to catch labor and material overages before they compound across multiple jobs.

What is an acceptable labor variance percentage?

Many well-run companies try to keep labor variance within 5 to 8 percent of the estimate. The exact target depends on job type and service mix.

Can landscape job costing software improve profitability?

Yes. When software connects estimating and job costing, you can see where profit shifts and adjust production rates, markups, and processes. Over time, that visibility stabilizes margins.

Do I need software to track actual vs. estimated costs?

You can track it manually, but as the job volume grows, spreadsheets become hard to maintain. Dedicated estimating and job costing software creates a consistent feedback loop that scales with your business.
